2026-02-22·10 min read·By Luis Salcedo

How to Prevent Scope Creep: The Agency Playbook

Scope creep is almost never the result of a client acting in bad faith. It is almost always the result of a brief that left something undefined, and two parties who filled the gap with different assumptions. By the time the scope creep surfaces, the brief is signed, the project is underway, and the conversation is more expensive than it should have been.

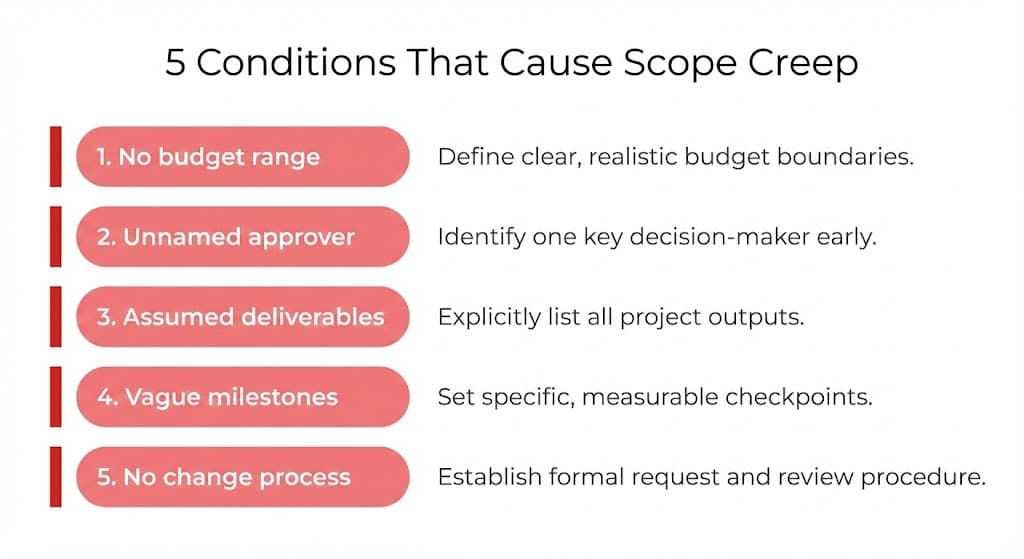

5 conditions that cause scope creep: no budget range, unnamed approver, assumed deliverables, vague milestones, no change process

Why scope creep starts before the first line of code

Scope creep is a discovery failure, not an execution failure. The gap that causes it exists in the brief, not in the build. By the time it surfaces, usually when a client asks for something the agency did not price, the misalignment has been present since the project began. Both parties were working toward different definitions of 'done'.

This is why responding to scope creep with better project management misses the cause. You can track tasks in Linear with perfect fidelity and still deliver a project that the client considers incomplete. The tracking is not the problem. The brief that the tracking is based on is the problem.

Preventing scope creep means closing the gaps in the brief before commitment, not managing the consequences of those gaps after the project starts. The five conditions below account for the majority of scope creep in agency projects. Each one is preventable at the discovery stage.

67%

of agency leaders say projects at least sometimes come in over budget.

Source: Teamwork.com, State of Agency Operations 2023 (survey of 512 agency leaders)

The 5 conditions that cause scope creep

38%

of agencies report frequent overservicing, and 37% of those cite poor scope-creep handling as the primary reason.

Source: Teamwork.com, State of Agency Operations 2023 (survey of 512 agency leaders)
ConditionWhat goes wrongBrief-level fix
No budget rangeScope expands to fill ambiguityRequire budget range on intake form
Unnamed approverRevision cycles don't endName the final approver, not just their role
Assumed deliverablesClient expects more than was pricedList every deliverable with explicit exclusions
Vague milestonesNo accountability for dependenciesBuild timeline backward with named dates
No change processEvery request becomes a goodwill decisionInclude written change request section in scope doc
Condition 1: Missing budget range

When the budget is undefined or described as 'flexible,' scope expands to fill the ambiguity. The client adds requests because they do not know what their money covers. The agency accommodates them because the budget conversation was never had. A defined budget range, even an approximate one, creates a shared constraint that makes scope conversations possible before they become disputes.

Condition 2: Undefined final approver

When the person who can actually stop a revision is not named in the brief, revision cycles do not end and they escalate. The project manager approves. Then someone above the project manager sees it and has notes. Then someone above them. Each layer adds a round of revisions that was not in the scope. Name the final approver, confirm their authority, and get their sign-off at each major milestone.

Condition 3: Assumed deliverables

When the brief says 'website' without specifying page count, platform, and included features, both parties build a mental model of what that means. The models are different. The agency prices for what they heard. The client expects what they imagined. The gap surfaces when the agency delivers what they scoped and the client asks where the rest of it is. List every deliverable by name, with explicit exclusions.

Condition 4: Vague timeline milestones

A launch date without intermediate milestones creates a hidden timeline risk. When the client delivers content three weeks late, there is no documented milestone they committed to. The delay becomes a negotiation about who is responsible for the launch date moving, rather than a straightforward invocation of a written dependency. Milestones with specific dates, written into the brief, make dependencies visible before they become disputes.

Condition 5: No change request process

Without a defined process for handling scope changes, every out-of-scope request becomes a goodwill decision. The first one is easy to say yes to. By the fourth one, the economics of the project no longer work and the agency is managing a relationship, not a scope. A written change request process with a minimum pricing threshold, an approval step, and a timeline impact statement makes every additional request a business conversation rather than a test of the relationship.

How to close each gap before the project starts

Each condition maps to a specific step in the discovery process:

For missing budget range

Make budget range a required field on your client intake form. If the client leaves it blank, follow up before scheduling a kickoff call. A client who will not commit to a range at the intake stage is a client who will expand scope without constraint during the project. This is a better-to-know-now risk.

For undefined final approver

Add two questions to your intake form: 'Who reviews deliverables?' and 'Who has final approval?' These are different questions. Get a name for each, not a role. Confirm in the brief that final approver sign-off is required before the agency proceeds from each milestone. Get the final approver's email on the distribution list from kickoff.

For assumed deliverables

Every deliverable in the brief should be named, scoped, and qualified. Use the pattern: [Output], [Format], [Platform], [Quantity]. Then add an explicit exclusions section: 'The following are not included in this scope.' List every common assumption that does not apply. If you are building a website, exclude the blog, the e-commerce module, and the languages you are not localizing for.

For vague timeline milestones

Build the timeline from dependencies, not deadlines. Start with the launch date and work backward: when does QA need to be complete? When does development need to start? When does content need to arrive? Each step becomes a milestone with a specific date. Document the dependency explicitly: 'Development start is contingent on design approval by [date].' When a milestone slips, the downstream impact is visible and documented.

For no change request process

Include a change request section in every scope document. The minimum viable version: 'Any changes to scope must be submitted in writing. Changes with an estimated cost above €X require written approval before work proceeds. All approved changes will affect the project timeline.' This is not a bureaucratic imposition. It is a mechanism that makes scope changes possible without burning the relationship.

What to do when scope creep has already started

Even with a complete brief, scope creep occasionally appears: a client request that is clearly outside scope, a deliverable that was ambiguously described, or a stakeholder who was not in the original agreement. When it happens, the goal is to resolve it without damaging the relationship.

The most effective approach is to acknowledge the request clearly, reference the scope document, and offer a path forward:

  • Acknowledge: 'We understand you need [request]. Thank you for flagging it.'
  • Reference: 'Our current scope covers [what is included]. This request falls outside that scope, specifically [relevant exclusion or missing specification].'
  • Offer a path: 'We can accommodate this as a change request. Here is what it would cost and how it would affect the timeline: [estimate]. Let us know how you would like to proceed.'

The key is not to frame the conversation as the client being wrong. They often genuinely believed the request was in scope. The framing is: here is what we agreed to, here is what you are asking for, and here is the path to get there. When there is a written scope document both parties signed, that conversation is much easier to have.

The absence of a written scope document turns the same conversation into a dispute about what was agreed. That is the conversation you are preventing by investing in discovery.

For mid-project scenarios, use these script and template extensions to keep change conversations structured and billable:

Use a direct script when a request is outside scope: How to tell a client something is out of scope

Set and enforce revision billing rules: How to charge for revisions

Document each change request before work starts: Website change request template

Use the fixed-price prevention framework end to end: How to prevent scope creep in fixed price projects

Build scope protection into every project from day one

The agencies that manage scope consistently are not the ones with the most aggressive contracts. They are the ones with the most complete briefs. A complete brief makes scope visible before commitment. A written change request process makes scope changes manageable when they occur. Together, they remove the ambiguity that scope creep lives in.

Clariva automates the brief completeness check. Paste any brief and Clariva scores it across all relevant dimensions, flags every gap with the specific condition it maps to (including the five above), and generates a brief pack with a scope definition your team can commit to.

Download a free project scope document template: Project scope document template

Or see the complete client onboarding checklist: Client onboarding checklist

Paste any brief. Clariva scores it across all relevant dimensions, flags every scope risk, and generates a brief pack ready for commitment.
